2021, Vol. 35, No. 1, 57-79
Revue Française de Gestion Industrielle
article en open accès sur www.rfgi.fr
A Review and Classification of the Uncertainties in Projects: The Way Forward
Amitabh Anand 1, Alessio Castello 2, Laurence Lecoeuvre3
1Excelia Business School, CERIIM, La Rochelle, France, ananda@excelia-group.com
2International University of Monaco–Omnes Education acastello@monaco.edu ,
3 Non-affiliate, laurence.lecoeuvre06@gmail.com
Abstract
This article aims to summarize existing research on various sources of uncertainty and to classify them based on the determinants and antecedents addressed in projects. A systematic review is conducted using a total of 140 research published in peer-reviewed scientific journals during the last three decades. We classify various uncertainty based on their individual, relational, group, organizational, project-oriented, and managerial characteristics. Additionally, we uncovered a few gaps such as, how uncertainties differ based on the size of the organization, the need for exploring uncertainty from a more cross-disciplinary perspective, differentiating the concept of complexity and risk with uncertainty and the role of chaos theory, that require future study. By leveraging significant findings, this is study contributes from the perspective of theory and practice to academic, project, and industrial management discipline.
Keywords : Project Management; Uncertainty; Project Uncertainty; Systematic Reviews
Revue et classification des incertitudes dans les projets : la voie à suivre
Résumé
L'objectif de cet article est de résumer les recherches existantes sur les différentes sources d'incertitude et de les classer en fonction des déterminants et des antécédents abordés dans les projets. Une revue systématique est réalisée à partir d'un total de 140 recherches publiées dans des revues scientifiques à comité de lecture au cours des trois dernières décennies. Nous classons les différentes incertitudes en fonction de leurs caractéristiques individuelles, relationnelles, de groupe, organisationnelles, orientées vers le projet et managériales. En outre, nous avons découvert quelques lacunes telles que la manière dont les incertitudes diffèrent en fonction de la taille de l'organisation, la nécessité d'explorer l'incertitude dans une perspective plus interdisciplinaire, la différenciation des concepts de complexité et de risque avec l'incertitude et le rôle de la théorie du chaos, qui nécessitent une étude future. En s'appuyant sur des résultats significatifs, cette étude contribue, du point de vue de la théorie et de la pratique, à la discipline de la gestion universitaire, de projet et industrielle.
Mots clés : Gestion de projet; Incertitude; Incertitude du projet ; Revue systématique
Over the last three decades, a substantial quantity of literature on project management (PM) has been published (Söderlund, 2011), and the discipline has evolved into a critical business practice for many organizations, both strategically and operationally (Perminova et al. 2008). PM also entails a set of procedures, planning tools, and factors for time, scope, quality, and budget to ensure successful execution (Padalkar and Gopinath, 2016). However, project management issues are arising in part as a result of increased commercial risks (e.g. Saleh and Watson, 2017). Practitioners assert that the uncertainty effect is one of the general characteristics of projects, emerging in technical, organizational, and social contexts (Bohle et al. 2016); uncertainty is frequently viewed as a natural aspect of project life (Saunders et al. 2016).
Uncertainty is believed to occur because of a variety of ambiguous and complex causal events underpinning an organization's internal processes and external environment (Colorado, 1999; Karlsen, 2011). Additionally, it may emerge because of project delays, quality difficulties, insufficient time and resources spent during the initial pre-planning and planning phases, and an inability to cope effectively with unforeseen events that occur during the project's execution (Johansen et al. 2016).
Uncertainty is multifaceted and complex and depends on the issue at hand (Johansen et al. 2016; Wazed et al. 2009). For example, from a situational standpoint, it occurs when (1) the order or nature of things is unknown, (2) the consequences, extent, or magnitude of circumstances, conditions, or events is unpredictable, (3) credible probabilities to possible outcomes cannot be assigned (see “Knightian uncertainty,” Alvarez et al. 2018, based on Knight, 1921); and (4 (Starbuck and Milliken, 1988). Uncertainty is defined by Lindau and Lumsden (1995) as a type of disturbance and the psychological state of doubt about what current events mean or what future events are likely to occur (in Milliken 1987). Uncertainty is also linked to a lack of knowledge in terms of knowledge and information. For example, Funtowicz and Ravetz (1990) define it as a circumstance in which there is insufficient information in three dimensions. Imprecision, Unreliability is number two, and ignorance is number three. Doubt can even arise when there is an abundance of knowledge available (Van Asselt and Rotmans, 2002), and extra information does not always diminish uncertainty.
Uncertainty has been addressed in a variety of ways across disciplines and approaches (Saunders et al. 2015), and managing uncertainty is regarded as a critical component to improving performance (Perminova et al. 2008). While uncertainty is a hot topic among management scholars (Alvarez et al. 2018; Teece and Leih, 2016), it is frequently overlooked by practitioners (Martinsuo et al. 2014; De Meyer et al. 2002), and its causal factors in projects are poorly understood. Recent literature reviews on uncertainty and risk in project management (e.g., Saunders et al. 2017), managing uncertainty in projects and its gaps and trends (Zheng and Carvalho, 2016), or literature reviews to define uncertainty in projects and project management can be found (Perminova et al. 2008). However, understanding the underlying antecedents that have an impact on projects necessitates a structured approach to dealing with uncertainty. Furthermore, this can only be accomplished if scholars conduct a thorough investigation of the phenomenon.
As numerous authors emphasize, there is an imperative need for classification of uncertainty research and a better understanding of uncertainty in projects (Witt et al., 2017; Saunders et al., 2017), as well as a need for a new perspective on uncertainty; because uncertainties frequently arise during the project, it may be impossible to define them at the outset (Bohle et al. 2016). For example, the presence of uncertain information increases the risk associated with choice (Koleckzo. 2012), poses a challenge to managers (Kvalnes, 2016), and may lead to successful project outcomes. Understanding the many sources of project uncertainty and dealing with them requires managers' knowledge and skills (Korhonen et al. 2014). (Saunders et al. 2015).
Although many authors have attempted on identifying uncertainties in projects, yet it remains dispersed. For instance, Miller and Lessard (2001) classified project management uncertainties into three categories: market-related uncertainties, such as demand, competition, and the supply chain; completion-related uncertainties, such as technical, construction, and operational; and institutional uncertainties, such as regulatory, cultural, and extra-national. Similarly, Leifer et al. (2001) classify uncertainty into four broad categories: technological, market, organizational, and resource. Pich et al. (2002) highlighted managerial techniques and classified uncertainty in projects into four categories: variance, anticipated uncertainty, unanticipated uncertainty, and chaos. Ward and Chapman (2003), on the other hand, identify five: estimation variability, estimation uncertainty, design and logistics, goals and priorities, and basic connections amongst project stakeholders. Zhu et al. (2005) classified uncertainty in projects into two categories: minor deviations and disruptions. Deviations are frequently observed as a result of wild fluctuations in task durations, specifically. Disruptions, on the other hand, are uncommon, unplanned events, such as the incidence of natural disasters or the unexpected departure of important team members. Hazir and Ulusoy (2020) distinguished between internal and external uncertainty in initiatives. Internally produced uncertainties concern systems and resources that are directly related to the project and are primarily within the organization's control. Many additional uncertainties, on the other hand, are created by variables outside the scope of the project and hence cannot be controlled by the organization. These are regarded as externally induced uncertainty. However, the comprehensive review of all uncertainties encompassing in a project is yet to be developed, and with this in mind, and to the best of our knowledge, our work attempts to repertory and categorize the various causes of uncertainty in projects through a more detailed analysis and also advance the literature on providing distinct classification compared and contributing to previously found uncertainties in projects.
This paper contributes to both academic and project and industrial managerial efforts by offering a structured analysis of the existing literature on uncertainty in projects. Although uncertainty as a term has been used interchangeably with risk, volatility, or complexity, uncertainty includes all identified risks, but the risk doesn't include uncertainty (Lechler, Edington, & Gao, 2012, p. 59). Sommer & Loch (2004, p. 1335–1336) treat complexity and “unforeseeable uncertainty” as separate constructs while noting that the use of the term “complexity” is not consistent in the PM literature. Thus to avoid ambiguity, in this study we adopt only uncertainty as the keyword to perform reviews.
More precisely, our goal is to understand the determinants and antecedents of uncertainty in projects. In doing so, we introduce the classification of uncertainty according to the various sources, whether they are internal or external to the project; and the element on which its effect is more relevant: individual, project team, or organization. As seen, our work identifies several weaknesses in current approaches to uncertainty, starting from its definition and the difference between uncertainty, risk, and complexity. Also, there are several industries, geographical areas, and types of projects that remain largely unexplored by scholars. By highlighting these shortfalls, we hope to encourage scholars to direct their efforts in specific directions. We also facilitate managers whose efforts in dealing with uncertainty can be optimized by adopting a pragmatic approach when confronted with uncertainty: our classification enables them to quickly identify the sources of the specific uncertainty that they are confronted with and better target the countermeasures.
In this section, we lay out a detailed step-by-step approach to performing a systematic literature review using bibliometric methods following the suggestions of Tranfield et al. (2003) and used by Aguinis et al. (2018). The goal is to apply a structured, transparent, and reproducible methodology to analyze published knowledge through a synthesis of existing research evidence. Ultimately, the aim is to produce a new and original research output (Light and Pillemer, 1984); Cooper, 1989; David and Han, 2004; Torchia and Calabrò, 2019). According to these scholars, certain fundamental principles must be addressed to guarantee the required scientific rigor, namely:
First: ensure a transparent search: a systematic literature review requires a detailed description of all the search criteria, including the databases used, search strings, and rationale behind the choice of keywords (Denyer and Neely, 2004).
Second: describe the process step-by-step: since the goal of a systematic literature review is to structure a certain body of knowledge, which is often fragmented and complex, the reader must be able to follow each step of the review in an easily repeatable way (Tranfield et al., 2003).
Third: follow consistently the purpose of the research: the perspective of the authors must be clearly stated, thus allowing the generation of a valuable scientific contribution. The research purpose offers guidance in establishing the criteria for selecting the articles to be included in the systematic literature review (Pittaway et al., 2004). To apply these principles and ensure the necessary scientific rigor to our review, we have followed a seven-step process, detailed hereafter, to select and analyze the content of the articles to be included in the review. As a first step, we selected Elsevier’s ‘Scopus’ database to extract articles due to its coverage of a large collection of scientific journals. Scopus is user-friendly, time-saving, provides sorting and ranking features, and refining capabilities compared to other databases like Web of science, and Google-scholar (Harzing and Alakangas, 2017; Chadegani et al. 2013).

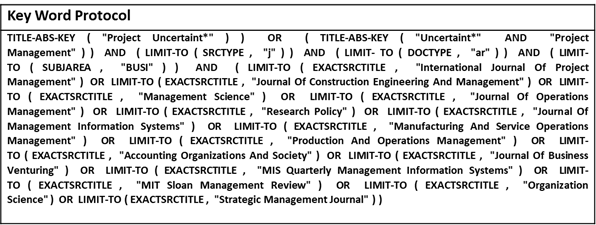

As a second step, a keyword protocol (see Table 1) search was performed in the Scopus database as mentioned below. To ensure we do not leave any potentially relevant articles unnoticed, a search using an asterisk was adopted. An asterisk (*) can substitute for the absence of a character, a single character, or multiple characters, anywhere in a word e.g. uncertain, uncertainty, uncertainties
As a third step, we decided to select only peer-reviewed journal articles. Although various categories of documents appear in Scopus (e.g, book, book chapters, conference papers, weblogs, and journal articles) we selected only articles from peer-reviewed scientific journals as suggested by Thyer (2008): when compared to venues such as books, book chapters, weblogs, and presenting papers at conferences, journal articles are of high prestige and merit within the scientific community. Moreover, journal articles are commonly considered representative of methodological rigor in systematic literature reviews (Pare et al. 2016).
As a fourth step, considering the purpose of our project, articles were selected only from the disciplines of business and management, and we excluded many others (e.g. medicine, social science, decision science, etc.).
Table 1: Keyword Protocol used for extracting articles from Scopus
As a fifth step, we decided to select those journal publications that are reputed, have good citations, impact factor and rankings (Harzing, 2017), we adopted Scopus metric analysis that categorizes results into 1) CiteScore, 2) SJR (Scimago journal rank), 3) highest number of documents, 4) highest number of citation 5) SNIP (source normalized impact per paper) ranking, etc. (see table 1); from these rankings, we selected the two highly ranked journals: “International Journal of Project Management” and “Journal of Construction Engineering and Management”. Second, using the suggestion of Söderlund (2011), we extended our search beyond the conventional project management journals and selected journals from the Financial Times top 50. The combination of these journals yielded us a total of 263 documents. The methodological process of our literature review is explained in Figure-1.

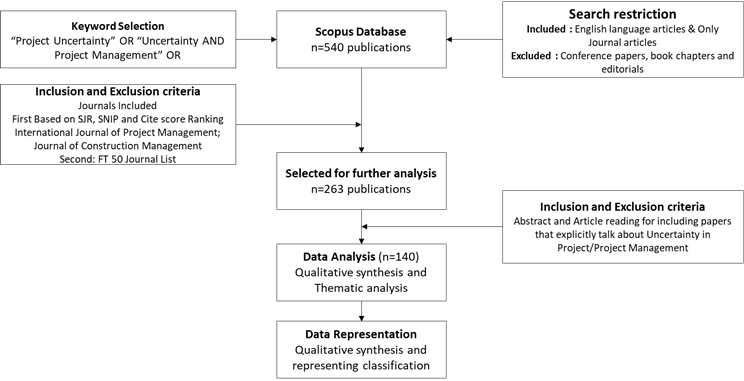

Figure 1: Methodological Process used in our study
As a sixth step, we adopted inclusion and exclusion criteria based on the following framework. Each author independently studied the abstracts of the obtained 263 articles and selected only those that address e.g. a) explicitly address the concept of uncertainty in projects, either in their title, abstracts or in the keywords b) we then read the abstracts to understand the context of uncertainty from an individual, group, organizational or others relevant perspective. After a series of readings, an inter reliability re-reading was done carefully. This resulted in 140 articles (see table 2 and table 3) as the final sample and we left other papers as they did not match our criteria.
Table 2: Journal and number of articles extracted from Scopus metrics
Name of the Journals |
Numbers selected |
International Journal of Project Management |
79 |
Journal of Construction Engineering and Management |
39 |
Table 3: Journals listed in Financial Times top 50 and number of articles extracted
Name of the Journals |
Numbers selected |
Accounting, Organizations and Society |
1 |
Journal of Business Venturing |
1 |
Journal of Operations Management |
5 |
Management Science |
7 |
Manufacturing and Service Operation Management |
1 |
MIT Sloan Management Review |
1 |
Organization Science |
1 |
Research Policy |
4 |
Strategic Management Journal |
1 |
s a seventh step, the retrieved articles were subjected to review. In our reviews, we adopt a replicable, scientific, and transparent process to minimize bias and create consensus among scholars (Cooper, 1998; Tranfield et al. 2003). The process implies performing a synthesis (Mays et al. 2005), as synthesis is the core of all methodological approaches, we decided that all authors would read independently all the abstracts and code the data and classify them into different categories (e.g. context, variables, methodologies, consequences, and outcomes) according to a common classification procedure and provide meaningful interpretation through tables (Oxman 1994; Walsh and Renaud, 2017). Table matrix helps to organize the information in a logical order, the topics that are in common with authors or articles, methodological similarities, and differences, measurement tools (e.g. experiments, narrative inquiry, quantitative methods, qualitative or mixed-method, etc.), focused group (individual, dyadic or group, etc.) (Galvan, 2006).
Based on the content analysis of the 140 articles, we identified five main axes of various antecedents and determinants related to uncertainty. 1) Individual, 2) relational, 3) organizational, 4) group, 5) project-specific, and 6) managerial. These uncertainty factors seemingly affect projects, budgets, project managers, employee performance, and overall organizational growth.
Employees, managers, subordinates, and a variety of other project participants play a larger role in the implementation phase. Certain qualities, on the other hand, may cause project uncertainty. Conscientiousness and openness to experience (Witt et al. 2017), situational behavior (Baloi and Price, 2003; You et al. 2018), individual belief system (Wong et al. 2008), norms, and cultural beliefs (Javernick-Will and Scott, 2010), trust, work ethics and values (Badenfelt, 2011), confidence, willingness, and expectation (Wong et al. 2008) are some of the dispositional and personality factors that are known to affect projects.
On the other hand, factors related to the individual role in project management and dealing with projects, such as task type (Vaziri et al. 2007), attractiveness towards the project (Gil, 2007), professional skills (Zika-Viktorsson et al. 2003), perceived view of the project (Olsson, 2007), lack of commitment (Gällstedt, 2003), and lack of motivation (Lehner, 2009), influence uncertainty. Furthermore, stress from time constraints (Leung et al. 2008), manager pressure (De Marco et al. 2016), participation (Jun et al. 2011), involvement (Gales and, Mansour-Cole, 1995), and communication all contribute to project execution uncertainty.
Numerous interactions, including project managers' behavior toward employees (Kutsch and Hall, 2005), a lack of leadership values (Wouters et al. 2009), senior executives' relationships with employees (Phua, 2007), interpersonal relationships, and conflict with other employees (Mitropoulos and Howell, 2001; Liu et al. 2011), and the leader's attitude toward the group (Tysseland 2008), have been reported to contribute to uncertainty (Pesämaa et al.. 2009). Furthermore, collaborative climate (i.e. the trust and commitment among partners) (Eriksson, & Westerberg, 2011) lack of inter-organizational collaboration (trust and control) (Kalkman and Waard, 2017), information feedback, face to face meetings, time and attention from project participants (Sakka et al. 2016), user participation (Jun et al. 2011), user involvement (Gales and, Mansour-Cole, 1995), and stakeholder’s motives (Ward and Chapman, 2003).
From a group perspective the antecedents of uncertainty are functional diversity (Dayan et al. 2017), group values, norms (Wong et al. 2010), group cultures (Naveh 2007), lack of effective interaction (Blacud et al. 2009), lack of efficient cooperation (Pesamaa et al. 2009), lack of involvement by group members (Verworn, 2009), group and managerial conflicts (Laslo and Goldberg, 2008), lack interpersonal performance (Leung et al. 2008), group culture practices (van Marrewijk et al. 2008), lack of being active members (Olsson 2007), lack of experience (Mitchell and Nault B.R. 2007), trust and relationship issues (Wong et al. 2008), lack of co-operation and collaboration (Zhang et al. 2017) and lack of financial feasibility (Farrell, 1995).
Particularly for projects in the implementation phase, uncertainty may arise from human resource issues (Zwikael and Sadeh 2007), resource constraints (Long and Ohsato, 2008), lack of schedule control (Wang and Liu 2005), lack of information (Danilovic and Sandkull, 2005), lack of clear communication (Verworn, 2009), insufficient support (Olsson 2007), time spent on transfer of information (De Treville et al. 2004), tasks duration, resources allocation (Vaziri et 2007), subjective judgments (Choi et al. 2004), decision making judgments (Kutsch and Hall 2005; Lin and Chen 2004; Hashemi et al. 2011), unfamiliar environments, with differing regulations, (Javernick-Will and Scott, 2010), adapting to new technology and rate of return with projects (Nobelius 2004), management styles and project infrastructures (De Meyer et al. 2002). Furthermore, time pressure (Leung et al. 2008) dynamic social structure and procurement decisions (Tysseland 2008), project design, and cooperation (van Marrewijk et al. 2008) are found to influence the uncertainty in projects.
Organization structure (Laslo and Goldberg, 2008) and climate also found to create uncertainty in projects e.g. project operation environment (Laslo and Goldberg, 2008), organizational environment (Jensen et al. 2006; Olsson 2007), lack of organizational flexibility and capabilities (Sommer et al. 2009; Hawk et al. 2013), corporate culture (Chapman et al. 2006). Also, any organizational change and flexibility in projects (Olsson 2006) may create uncertainty. Furthermore, contracting issues (Wong et al. 2008) and customer expectation, satisfaction (Naveh, 2007) influence uncertainty. Work, capital cost, decision making (Sundararajan and Tseng, 2017), two exogenous variables - mediated power and non-mediated power of client - and three endogenous variables - client integration, contractor integration, and project performance, all play a role (Pesamaa et al. 2009). Also, political environment (Zayed et al. 2008), organizational climate and culture (Perminova et al. 2008), organization knowledge about cost information, financial condition and ability to bear the project cost (Xiang et al. 2015), delay in project payments (Kwon et al. 2010), price competition (Christen, 2005) budget contingency, schedule contingency, management reserve, quality issues (Bushuyev and Sochnev 1999), international transactions (bid behavior) (Han et al. 2005) influence uncertainty in projects.
Some authors assert that an organization's role in assessing employee contribution can also have an impact on projects, e.g. evaluation methods (Chapman and Ward, 2000) and project appraisal. Organizational maturity (Zwikael and Sadeh 2007), aggressive/passive management strategies on managing cost (Li et al. 2013; Hegazy and Ayed 1998), timeliness and facility value (Ford, 2002), and adequate resources and funding supply conditions (Yang and Chang 2005) can cause uncertainty in projects. market payoffs, product performance, market requirements, create uncertainties in projects (Huchzermeier and Loch, 2001).
Includes the antecedent’s influencing uncertainty at the different stages of projects, for instance, type and nature of the project, project management approaches, project planning, project selection (Thiry, 2002; Howell et al. 2010; Shenhar, 2001; Chapman et al. 1985; Dean 1986; Ghapanchi et al. 2012). Factors such as project risk (Acebes et al, 2014, 2015) project duration, size, estimation (Lee et al. 2009; Moussa et al. 2007; Chapman 2006; Arashpour et al. 2016; Barraza, 2011; Caron et al. 2016), project portfolio (Martinsuo et al. 2014; Petit, 2012), project operational goals (Tatikonda and Montoya-Weiss, 2001), project design (Ramasesh and Browning, 2014), project delays and overlaps, (Mitchell and Nault 2007; Dehghan, and Ruwnapura, 2014). Characteristics such as information technology (Bardhan et al. 2007), project knowledge (Ahern et al. 2014; Laine et al. 2016; Dikmen et al. 2012), profit (Gopal et al. 2003), rate of return (Nobelius, 2004), project cost, (Elkjaer, 2000; Farshchian et al. 2018), over-head cost (Goh and Hall, 2013) project budget (Günhan and Arditi, 2007), disruptions (Schatteman, 2008; Aaltonen, 2011), rescheduling cost (Bordley et al. 2019; Xiang et al. 2012), accounting information (Van Der Velde et al. 2002), performance and decision environment (e.g., criteria weights, total budget) overlapping strategies, workforce control policies, and schedule adjustments (Pena-Mora and Park, 2001), development schedules (Nightingale, 2000).
Furthermore, organizational process factors such as product development capabilities, operational/market performance in product development projects (Tatikonda and Montoya-Weiss 2001; Turner and Simister 2001), project duration overrun, loss of key project personnel, absence of recognition and allowance (Chapman, 1998), lack of client satisfaction, lack of precision in finishing projects (Brodetskai et al. 2013), lack integration between the organization and its projects (Vuorinen et al. 2018 ) quality deficiencies (Arashpour et al. 2016), cost estimating procedures (Diekmann and Featherman, 1998), project situations (Laufer and Cohenca, 1990; Chapman et al. 1985), project schedule and man-hour variance (Laufer, 1991) and role of project manager and their performance (Turner and Müller, 2003). Uncertainties may also arise from the type of contracting and subcontracting agreements (Cardenas et al. 2017 and Choudhry et al. 2012), control modes, and control mechanisms fairness, and culture integration mechanisms.
Further, Dawson and Dawson (1995) and Pillai and Tiwari (1995), suggested that network structure in the project activity can cause uncertainty; also, the complexity of the methods involved and the lack of easy to use tools (Dawson and Dawson, 1998), project resources (Padilla and Carr 1991), project initiation, postponements to avoid unfavorable restoration conditions, (Hwang et al. 2016), probability estimation (Moret and Einstein, 2012) lack of information, ambiguity, characteristics of project parties, tradeoffs between trust and control mechanisms, (Atkinson et al. 2006), lack of project contingency (Dey et al. 1996) effectiveness and efficiency, create uncertainties in the project.
Managerial specificities among the uncertainty effects on projects are reported in management practices such as management control systems (Davila, 2000), manager skills (Baqerin et al. 2016), managerial flexibility (Koppenjan et al. 2011), managerial decisions (Sauser et al. 2009; Santiago et al. 2005). Furthermore, technological, organizational, and social contexts (Böhle, et al. 2016), socio-technical environments, sense of balancing competing demands, and provided evidence of learning, acting mindfully, avoiding over-rigid processes, and upholding constructive tensions, conceptual slack and close interdisciplinary working (Saunders et al. 2016), variable compensation, organizational structure (Davila, 2003), co-ordination between clients and consultants (Scott and Harris, 2004), political behavior (Svejvig and Andersen, 2015), incentive provision and decisions (Liu et al. 2018) exogenous technological change, failure to search strategy (Chandrasekaran et al. 2016), influence uncertainty in projects.

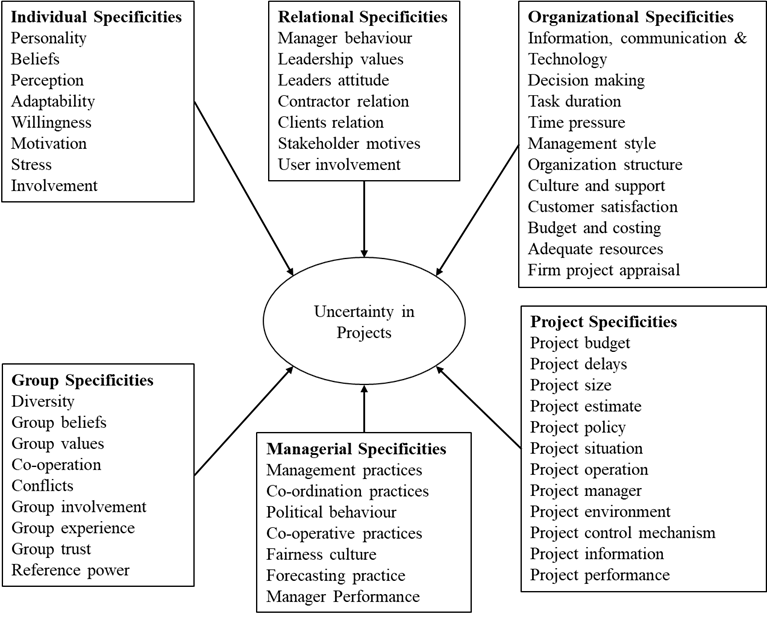

Figure 2 Summary of the key classification of sources of uncertainty in projects.
Figure 2 allows us to develop a classification for the various sources of uncertainty in projects. This is composed of six categories since uncertainty can originate from an individual, group, managerial, organizational, relationship, and project specificities. We reported certain factors in multiple categories since different scholars relate the same factor to different sources.
The findings of this research contribute to the field of project management and for project managers in two ways: firstly, our findings help scholars in advancing and better understanding the sources of uncertainty by classifying them into six separate categories, dealing with these issues individually can provide better opportunities for future research; secondly, the antecedents and determinants presented here can support project managers, practitioners and researchers in developing solutions applicable to specific projects.
The classified uncertainties will be able to foresee and define occurrences to assist stakeholders and project managers in developing contingency plans typically the degree of uncertainty for a specific project (e.g. oil and gas context, hydroelectric power, nuclear, geothermal, etc.). This study demonstrates that the degree of uncertainty associated with the classification has a direct effect on the project's success when stakeholders, firms, and project staff are involved. The work contributes insights into how to better manage industrial projects within the context of uncertainty, as industrial projects are part of execution by many big firms such as Total, Alstom, etc. Thus, the findings from this study will help industrial project managers (who are involved in design, construction, planning, execution, etc.) to be aware of and respond to uncertainty factors classified in this study. The study implications are the developed framework, which can be used as a guideline to better plan the responses to uncertainties in industrial projects.
In addition to incorporating the aforementioned taxonomy for sources of uncertainty, our literature review helps us to recognize some additional primary findings important to discipline study and help shape future research:
Dealing with uncertainty is an inherent part of project management: an adequate strategy is required to improve project performance, particularly in large projects. Nevertheless, most literature focuses on heavy engineering and construction industries; however, from the reviews, we found that the discipline of uncertainty resides mainly in massive or mega projects (Daniel and Daniel, 2018); in particular, we found various studies on oil and gas, public and government building projects, nuclear projects, defense, and rail projects. Therefore, the impact of uncertainty as a function of the project's size is missing evidence. Future research should therefore study how uncertainty varies by organization size and project size (e.g. small projects, medium projects, and mega projects).

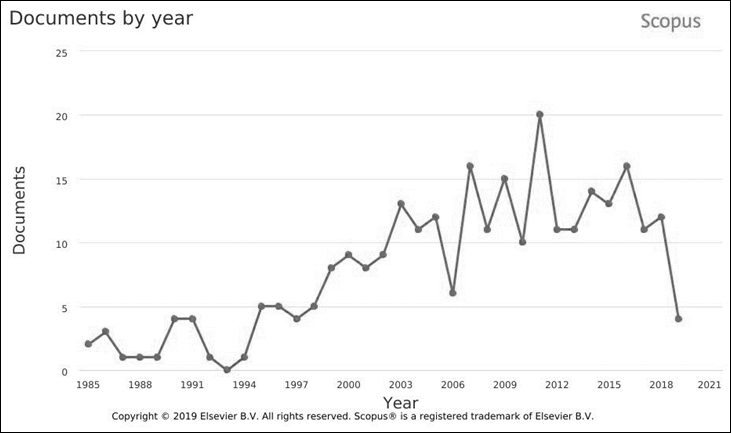

There is a steady growth of uncertainty literature in several disciplines: the literature on uncertainty has been growing over the last two decades (see figure 3). For instance, increased awareness of uncertainty and risk management appeared in literature particularly given the backdrop of sensational financial collapses of major corporate and banking institutions (Harvett, 2013). Statistics obtained from the Scopus database indicate that the number of articles published around uncertainty in project literature has doubled since 2010 (see figure 3). This also confirms that the topic of uncertainty started to emerge as a new sub-topic of project management.
Fig 3: The growth of documents on the topic of uncertainty in projects

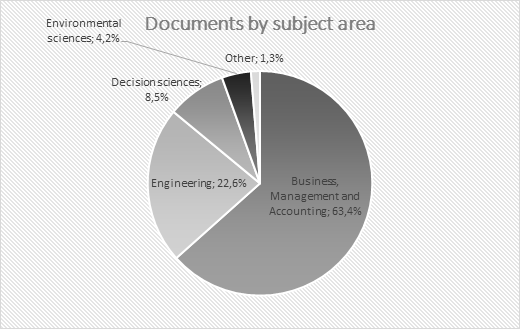

Further analysis of the obtained dataset shows how most of the literature focuses on engineering, business, and management disciplines (see figure 4); this high concentration in specific domains may have introduced a bias on the efforts done by scholars to understand the sources of uncertainty. Nevertheless, the growing interest of researchers from other disciplines like computer science suggests that managing technological and software projects is also increasingly threatened by uncertainty. Therefore, our research calls for more cross-disciplinary studies.
Figure 4: The multidisciplinary literature about uncertainty in projects

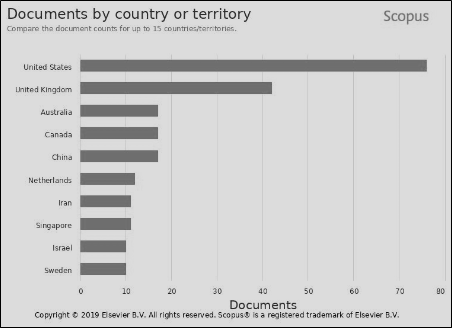

Finally, from our datasets, it emerges that the biggest contributors to the uncertainty literature are authors from the US and the UK (see figure 5). Therefore, we cannot exclude a bias in the findings of research activities due to this geographic concentration. Consequently, we call for more international studies.
Fig 5: The Major continents contributing to uncertainty literature
There is a need for better differentiating between the concepts of risk, uncertainty, and complexity: uncertainty is often closely associated, and even sometimes interchangeably used, with risk and complexity (Sommer et al. 2009; Turner and Cochrane, 1993; Williams, 2005; Bos-de Vos et al. 2019). Daniel and Daniel (2018) state that “degrees of uncertainty and complexity is embedded [in projects], uncertainty being a characteristic of the management subsystem, and complexity being a characteristic of the project management system”. Moreover, confusing risk and uncertainty, implies that both are treated alike (Perminova et al. 2008). The confusion is potentially harmful since it tends to focus attention on planning and operational control, at the expense of strategic issues (Atkinson et al. 2006).
We argue that more clarity should be adopted by researchers in using the different terms; in particular, risk should be adopted to describe an event or condition that has a quantifiable probability of occurring, and that, if it occurs, has a positive or negative effect on a project objective (Ward and Chapman, 2003); complexity for situations in which systems are complex, i.e. the interactions between different components are hard to model and evolve (San-Cristobal, 2017); finally, uncertainty should be reserved to those situations in which credible probabilities to possible outcomes cannot be assigned as certain events cannot be predicted (Alvarez et al. 2018, based on Knight, 1921). Our call for clarity in the terminology is supported by several scholars who report confusion in the use of different terms (Padalkar and Gopinath, 2016).
Chaos theory may help to deal with uncertainty: De Meyer et al. (2002) asserted that “project managers can’t predict the future, but accurately gauging the degree of uncertainty inherent in their projects can help them quickly adapt to it”, such a recommendation is derived from drawing a parallel between uncertainty and chaos theory (Geraldi, 2008). Since its introduction during the 20th century, chaos theory has concentrated on studying systems that are highly sensitive to initial conditions: very little changes in the initial conditions produce considerably different results as illustrated by the famous butterfly effect, according to which “the flap of a butterfly's wings in Brazil may set off a tornado in Texas” (Lorenz, 1972). We endorse the line of thought that promotes the analogy with chaos theory to offer new insights in developing strategies to cope with uncertainty (Werndl, 2009; Thietart et al. 1985; Nychka et al. 1992) and we call for further research in this specific field.
This article contains few restrictions for further research. To begin, we limited our search to a subset of peer-reviewed journals, which may have excluded several articles. For instance, future research can examine the outcomes of this work focusing on project management-related journals such as Project Management Journal, International Journal of Management Projects in Business, IEEE transaction on Engineering and Management, etc. Second, while we justify our use of Scopus as a database, future research may benefit from studying data from other databases such as Google Scholar, Web of Science, and EBSCO. Due to the remarkable increase in the number of publications and journals, the study may examine the literature using bibliometric or scientometric approaches. Third, our study excludes conference papers and book chapters, which may have harmed generalizability.
In this paper, we presented a comprehensive review of the sources of uncertainties in projects and introduced a taxonomy based on individual, relational, group, organizational, project, and managerial specificities. When encountering uncertainties, the project manager faces many dilemmas (Zwikael, and Sadeh, 2007), identifying the appropriate source or sources of uncertainty among the six introduced in this article, may help the project manager to better cope with the unknown that may occur during various phases of projects. Our study confirms the increasingly central role that scholars studying project management attribute to uncertainty in projects: the number of article published in peer-reviewed journals kept growing steadily over the last years; also, academics point to the necessity for companies involved in projects to elaborate strategies to deal with uncertainty when it happens; another finding is that the literature studied shows that the terminology about uncertainty, risk and complexity lacks clarity and we invite scholars to adopt common definitions: we argue that risk should be used to describe an event or condition that may impact the outcome of the project and that has a quantifiable probability of occurring; complexity for situations in which the interactions between different components of a system are hard to model and evolve over time; finally, uncertainty should be reserved to those situations in which credible probabilities to possible outcomes cannot be assigned as certain events cannot be predicted.
Through this paper, we also open new avenues for future research; indeed, we have identified several gaps in existing literature, the most important of which are: the absence of studies investigating the impact of uncertainty as a function of firm and project size: most literature deals with large or mega projects only, leaving mid to small size projects uninvestigated; also, a large majority of articles treats of with oil and gas, construction, nuclear, defence and rail projects, hence the need to extend the area of investigation to other industrial sectors; there is an intense geographical concentration of authors writing on project uncertainty from Anglo-Saxon countries: we encourage scholars from other parts of the world to conduct local investigations of uncertainty in projects; finally, we highlight some interesting opportunities that may emerge from adopting tools and methods of chaos theory to cope with uncertainty in projects: we consider that further research in this field may prove very beneficial to support practitioners facing the challenges of uncertainty in projects.
Aaltonen, K. (2011). Project stakeholder analysis as an environmental interpretation process. International Journal of Project Management, 29(2), 165-183. https://doi.org/10.1016/j.ijproman.2010.02.001
Acebes, F., Pajares, J., Galán, J. M., & López-Paredes, A. (2014). A new approach for project control under uncertainty. going back to the basics. International Journal of Project Management, 32(3), 423-434. https://doi.org/10.1016/j.ijproman.2013.08.003
Acebes, F., Pereda, M., Poza, D., Pajares, J., & Galán, J. M. (2015). Stochastic earned value analysis using monte Carlo simulation and statistical learning techniques. International Journal of Project Management, 33(7), 1597-1609. https://doi.org/10.1016/j.ijproman.2015.06.012
Aguinis, H., Ramani, R., & Alabduljader, N. (2018). What You See is What You Get? Enhancing Methodological Transparency in Management Research. Academy of Management Annals 12, 1-28. https://doi.org/10.5465/annals.2016.0011
Ahern, T., Leavy, B., & Byrne, P. J. (2014). Complex project management as complex problem solving: A distributed knowledge management perspective. International Journal of Project Management, 32(8), 1371-1381. https://doi.org/10.1016/j.ijproman.2013.06.007
Alvarez, S.A., Afuah, A., Gibson, C. (2018) Should Management Theories Take Uncertainty Seriously? Academy of Management Review, 43(2), pp. 169-172. https://doi.org/10.5465/amr.2018.0050
Arashpour, M., Wakefield, R., Lee, E. W. M., Chan, R., & Hosseini, M. R. (2016). Analysis of interacting uncertainties in on-site and off-site activities: Implications for hybrid construction. International Journal of Project Management, 34(7), 1393-1402. https://doi.org/10.1016/j.ijproman.2016.02.004
Atkinson, R., Crawford, L., & Ward, S. (2006). Fundamental uncertainties in projects and the scope of project management. International Journal of Project Management, 24(8), pp. 687-698. 687-698. https://doi.org/10.1016/j.ijproman.2006.09.011
Badenfelt, U. (2011). Fixing the contract after the contract is fixed: A study of incomplete contracts in IT and construction projects. International Journal of Project Management, 29(5), 568-576. https://doi.org/10.1016/j.ijproman.2010.04.003
Baloi, D., & Price, A. D. F. (2003). Modelling global risk factors affecting construction cost performance. International Journal of Project Management, 21(4), pp. 261-269. https://doi.org/10.1016/S0263-7863(02)00017-0
Baqerin, M. H., Shafahi, Y., & Kashani, H. (2016). Application of weibull analysis to evaluate and forecast schedule performance in repetitive projects. Journal of Construction Engineering and Management, 142(2). https://doi.org/10.1061/(ASCE)CO.1943-7862.0001040
Bardhan, I. R., Krishnan, V. V., & Lin, S. (2007). Project performance and the enabling role of information technology: An exploratory study on the role of alignment. Manufacturing and Service Operations Management, 9(4), 579-595. doi: https://doi.org/10.1287/msom.1070.0163
Blacud, N. A., Bogus, S. M., Diekmann, J. E., & Molenaar, K. R. (2009). Sensitivity of construction activities under design uncertainty. Journal of Construction Engineering and Management, 135(3), 199-206. https://doi.org/10.1061/(ASCE)0733-9364(2009)135:3(199)
Barraza, G. A. (2011). Probabilistic estimation and allocation of project time contingency. Journal of Construction Engineering and Management, 137(4), 259-265. https://doi.org/10.1061/(ASCE)CO.1943-7862.0000280
Bohle, F., Heidling, E., & Schoper, Y. (2016). A new orientation to deal with uncertainty in projects. International Journal of Project Management, 34(7), pp. 1384–1392. https://doi.org/10.1016/j.ijproman.2015.11.002
Bordley, R.F., Keisler, J.M., Logan T.M. (2019) Managing projects with uncertain deadlines. European Journal of Operational Research, 274, pp. 291–302. https://doi.org/10.1016/j.ejor.2018.09.036
Bos-de Vos, M., Volker, L. Wamelink H. (2019). Enhancing value capture by managing risks of value slippage in and across projects. International Journal of Project Management, 37, pp. 767-783. https://doi.org/10.1016/j.ijproman.2018.12.007
Brodetskaia, I., Sacks, R., & Shapira, A. (2013). Stabilizing production flow of interior and finishing works with reentrant flow in building construction. Journal of Construction Engineering and Management, 139(6), 665-674. https://doi.org/10.1061/(ASCE)CO.1943-7862.0000595
Bushuyev, S. D., & Sochnev, S. V. (1999). Entropy measurement as a project control tool. International Journal of Project Management, 17(6), pp. 343-350. https://doi.org/10.1016/S0263-7863(98)00049-0
Cardenas, I. C., Voordijk, H., & Dewulf, G. (2017). Beyond theory: Towards a probabilistic causation model to support project governance in infrastructure projects. International Journal of Project Management, 35(3), 432-450. https://doi.org/10.1016/j.ijproman.2017.01.002
Caron, F., Ruggeri, F., & Pierini, B. (2016). A bayesian approach to improving estimate to complete. International Journal of Project Management, 34(8), 1687-1702. https://doi.org/10.1016/j.ijproman.2016.09.007
Chadegani, A, A., Salehi, H., Md Yunus, M. M., Farhadi, H., Fooladi, M., Farhadi, M., & Ale Ebrahim, N. (2013). A comparison between two main academic literature collections: Web of Science and Scopus databases. Asian Social Science, 9(5), pp. 18–26. https://doi.org/10.5539/ass.v9n5p18
Chandrasekaran, A., Linderman, K., Sting, F. J., & Benner, M. J. (2016). Managing R&D project shifts in high-tech organizations: A multi-method study. Production and Operations Management, 25(3), pp. 390-416. https://doi.org/10.1111/poms.12410
Chapman, B C., D Phillips, E., F Cooper, D., & Lightfoot, L. (1985). Selecting an approach to project time and cost planning. International Journal of Project Management, 3(1), pp. 19-26. https://doi.org/10.1016/0263-7863(85)90038-9
Chapman, C. (2006). Key points of contention in framing assumptions for risk and uncertainty management. International Journal of Project Management, 24(4), 303-313. https://doi.org/10.1016/j.ijproman.2006.01.006
Chapman, C., & Ward, S. (2000). Estimation and evaluation of uncertainty: A minimalist first pass approach. International Journal of Project Management, 18(6), pp. 369-383. https://doi.org/10.1016/S0263-7863(00)00016-8
Chapman, C., Ward, S., & Harwood, I. (2006). Minimizing the effects of dysfunctional corporate culture in estimation and evaluation processes: A constructively simple approach. International Journal of Project Management, 24(2), pp. 106-115. https://doi.org/10.1016/j.ijproman.2005.08.004
Chapman, R. J. (1998). The role of system dynamics in understanding the impact of changes to key project personnel on design production within construction projects. International Journal of Project Management, 16(4), pp. 235-247. https://doi.org/10.1016/S0263-7863(97)00043-4
Choi, H. -., Cho, H. -., & Seo, J. W. (2004). Risk assessment methodology for underground construction projects. Journal of Construction Engineering and Management, 130(2), pp. 258-272. https://doi.org/10.1061/(ASCE)0733-9364(2004)130:2(258)
Choudhry, R. M., Hinze, J. W., Arshad, M., & Gabriel, H. F. (2012). Subcontracting practices in the construction industry of Pakistan. Journal of Construction Engineering and Management, 138(12), 1353-1359. https://doi.org/10.1061/(ASCE)CO.1943-7862.0000562
Christen, M. (2005). Research note - cost uncertainty is bliss: The effect of competition on the acquisition of cost information for pricing new products. Management Science, 51(4), pp. 668-676. https://doi.org/10.1287/mnsc.1040.0320
Colorado, J. (1999). Managing Uncertainty in New Business Development, MS Thesis, Massachusetts Institute of Technology
Cooper, H. (1998). Synthesizing research: A guide for literature reviews (3rd ed.). Thousand Oaks, CA: Sage.
Cooper, A. C. (1989), Research findings in strategic management with implications for R&D management. R&D Management, 19, pp. 115-125. https://doi.org/10.1111/j.1467-9310.1989.tb00632.x
Daniel, P.A., Daniel, C. (2018). Complexity, uncertainty and mental models: From a paradigm of regulation to a paradigm of emergence in project management. International Journal of Project Management, 36, pp. 184-197. https://doi.org/10.1016/j.ijproman.2017.07.004
Danilovic, M., & Sandkull, B. (2005). The use of dependence structure matrix and domain mapping matrix in managing uncertainty in multiple project situations. International Journal of Project Management, 23(3), pp. 193-203. https://doi.org/10.1016/j.ijproman.2004.11.001
David, R. J. and Han, S. (2004), A systematic assessment of the empirical support for transaction cost economics. Strat. Mgmt. Journal, 25, pp. 39-58.
Davila, A. (2003). Short-term economic incentives in new product development. Research Policy, 32(8), pp.1397-1420. https://doi.org/10.1016/S0048-7333(02)00138-5
Davila, T. (2000). An empirical study on the drivers of management control systems' design in new product development. Accounting, Organizations and Society, 25(4-5), pp. 383-409. https://doi.org/10.1016/S0361-3682(99)00034-3
Dawson, C. W., & Dawson, R. J. (1995). Generalised activity-on-the-node networks for managing uncertainty in projects. International Journal of Project Management, 13(6), pp. 353-362. https://doi.org/10.1016/0263-7863(95)00027-5
Dawson, R. J., & Dawson, C. W. (1998). Practical proposals for managing uncertainty and risk in project planning. International Journal of Project Management, 16(5), pp. 299-310. https://doi.org/10.1016/S0263-7863(97)00059-8
Dayan, M., Ozer, M., & Almazrouei, H. (2017). The role of functional and demographic diversity on new product creativity and the moderating impact of project uncertainty. Industrial Marketing Management, 61, 144-154. https://doi.org/10.1016/j.indmarman.2016.04.016
De Marco, A., Rafele, C., & Thaheem, M. J. (2016). Dynamic management of risk contingency in complex design-build projects. Journal of Construction Engineering and Management, 142(2). https://doi.org/10.1061/(ASCE)CO.1943-7862.0001052
De Meyer, A., Loch, C. H., & Pich, M. T. (2002). Managing project uncertainty: From variation to chaos. MIT Sloan Management Review, 43(2), pp. 60-67
De Treville, S., Shapiro, R. D., & Hameri, A. -. (2004). From supply chain to demand chain: The role of lead time reduction in improving demand chain performance. Journal of Operations Management, 21(6), pp. 613-627. https://doi.org/10.1016/j.jom.2003.10.001
Dean, B. V. (1986). The project-management approach in the "systematic management" of innovative start-up firms. Journal of Business Venturing. https://doi.org/10.1016/0883-9026(86)90011-X
Dehghan, R., & Ruwnapura, J. Y. (2014). Model of trade-off between overlapping and rework of design activities. Journal of Construction Engineering and Management, 140(2). https://doi.org/10.1061/(ASCE)CO.1943-7862.0000786
Denyer, D. & Neely, A. (2004). Introduction to special issue: Innovation and productivity performance in the UK. International Journal of Management Reviews, 5, pp. 131-135. https://doi.org/10.1016/j.ijproman.2011.02.002
Dey, P. K., Tabucanon, M. T., & Ogunlana, S. O. (1996). Petroleum pipeline construction planning: A conceptual framework. International Journal of Project Management, 14(4), pp. 231-240. https://doi.org/10.1016/0263-7863(95)00092-5
Diekmann, J. E., & Featherman, W. D. (1998). Assessing cost uncertainty: Lessons from environmental restoration projects. Journal of Construction Engineering and Management, 124(6), pp. 445-451. https://doi.org/10.1061/(ASCE)0733-9364(1998)124:6(445)
Dikmen, I., Birgonul, M. T., Tah, J. H. M., & Ozer, A. H. (2012). Web-based risk assessment tool using integrated duration-cost influence network model. Journal of Construction Engineering and Management, 138(9), 1023-1034. https://doi.org/10.1061/(ASCE)CO.1943-7862.0000547
Elkjaer, M. (2000). Stochastic budget simulation. International Journal of Project Management, 18(2), pp. 139-147. https://doi.org/10.1016/S0263-7863(98)00078-7
Eriksson, P. E., & Westerberg, M. (2011). Effects of cooperative procurement procedures on construction project performance: A conceptual framework. International Journal of Project Management, 29(2), 197-208. https://doi.org/10.1016/j.ijproman.2010.01.003
Farrell, L. M. (1995). Feasibility analysis of artistic and cultural production projects. International Journal of Project Management, 13(6), pp. 395-401. https://doi.org/10.1016/0263-7863(95)00040-2
Farshchian, M. M., & Heravi, G. (2018). Probabilistic assessment of cost, time, and revenue in a portfolio of projects using stochastic agent-based simulation. Journal of Construction Engineering and Management, 144(5). https://doi.org/10.1061/(ASCE)CO.1943-7862.0001476
Ford, D. N. (2002). Achieving multiple project objectives through contingency management. Journal of Construction Engineering and Management, 128(1), pp. 30-39. https://doi.org/10.1061/(ASCE)0733-9364(2002)128:1(30)
Funtowicz, S.O. and Ravetz, J.R. (1990). Uncertainty and Quality in Science for Policy. Kluwer Academic Publishers, Dordrecht
Gales, L. and Mansour-Cole, D. (1995), “User involvement in innovation projects”, Journal of Engineering and Technology Management, Vol. 12 No. 1/2, pp. 77-109. https://doi.org/10.1016/0923-4748(95)00005-7
Gällstedt, M. (2003). Working conditions in projects: Perceptions of stress and motivation among project team members and project managers. International Journal of Project Management, 21(6), pp.449-455. https://doi.org/10.1016/S0263-7863(02)00098-4
Galvan, J. (2006). Writing literature reviews: a guide for students of the behavioral sciences (3rd ed.). Glendale, CA: Pyrczak Publishing
Geraldi, J. G. (2008). The balance between order and chaos in multi-project firms: A conceptual model. International Journal of Project Management, 26, pp. 348 – 356. https://doi.org/10.1016/j.ijproman.2007.08.013
Ghapanchi, A. H., Tavana, M., Khakbaz, M. H., & Low, G. (2012). A methodology for selecting portfolios of projects with interactions and under uncertainty. International Journal of Project Management, 30(7), 791-803. https://doi.org/10.1016/j.ijproman.2012.01.012
Gil, N. (2007). On the value of project safeguards: Embedding real options in complex products and systems. Research Policy, 36(7), pp. 980-999. https://doi.org/10.1016/j.respol.2007.03.004
Goh, J., & Hall, N. G. (2013). Total cost control in project management via satisficing. Management Science, 59(6), 1354-1372. https://doi.org/10.1287/mnsc.1120.1653
Gopal, A., Sivaramakrishnan, K., Krishnan, M. S., & Mukhopadhyay, T. (2003). Contracts in offshore software development: An empirical analysis. Management Science, 49(12), 1671-1683. https://doi.org/10.1287/mnsc.49.12.1671.25120
Günhan, S., & Arditi, D. (2007). Budgeting owner's construction contingency. Journal of Construction Engineering and Management, 133(7), pp. 492-497. https://doi.org/10.1061/(ASCE)0733-9364(2007)133:7(492)
Han, S. H., Diekmann, J. E., & Ock, J. H. (2005). Contractor's risk attitudes in the selection of international construction projects. Journal of Construction Engineering and Management, 131(3), pp. 283-292. https://doi.org/10.1061/(ASCE)0733-9364(2005)131:3(283)
Harvett, C. 15 Jun 2013; A Study of Uncertainty and Risk Management Practice Related to Perceived Project Complexity – Doctoral thesis.
Harzing, A.W. and Alakangas, S. (2017), "Microsoft Academic: Is the Phoenix getting wings?", Scientometrics, Vol. 110 No. 1, pp. 371-383. https://doi.org/10.1007/s11192-016-2185-x
Hashemi, H., Mousavi, S. M., & Mojtahedi, S. M. H. (2011). Bootstrap technique for risk analysis with interval numbers in bridge construction projects. Journal of Construction Engineering and Management, 137(8), 600-608. https://doi.org/10.1061/(ASCE)CO.1943-7862.0000344
Hawk, A., Pacheco-De-Almeida, G., & Yeung, B. (2013). Fast-mover advantages: Speed capabilities and entry into the emerging submarket of atlantic basin LNG. Strategic Management Journal, 34(13), 1531-1550. https://doi.org/10.1002/smj.2085
Hegazy, T., & Ayed, A. (1998). Neural network model for parametric cost estimation of highway projects. Journal of Construction Engineering and Management, 124(3), 210-218. https://doi.org/10.1061/(ASCE)0733-9364(1998)124:3(210)
Howell, D., Windahl, C., & Seidel, R. (2010). A project contingency framework based on uncertainty and its consequences. International Journal of Project Management, 28(3), pp. 256-264. https://doi.org/10.1016/j.ijproman.2009.06.002
Huchzermeier, A., & Loch, C. H. (2001). Project management under risk: Using the real options approach to evaluate flexibility in R&D. Management Science, 47(1), pp. 85-101. https://doi.org/10.1287/mnsc.47.1.85.10661
Hwang, S., Park, M., Lee, H. -., & Lee, S. (2016). Hybrid simulation framework for immediate facility restoration planning after a catastrophic disaster. Journal of Construction Engineering and Management, 142(8). https://doi.org/10.1061/(ASCE)CO.1943-7862.0001146
Javernick-Will, A. N., & Scott, W. R. (2010). Who needs to know what? institutional knowledge and global projects. Journal of Construction Engineering and Management, 136(5), 546-557. https://doi.org/10.1061/(ASCE)CO.1943-7862.0000035
Jensen, C., Johansson, S., & Löfström, M. (2006). Project relationships - A model for analyzing interactional uncertainty. International Journal of Project Management, 24(1), pp. 4-12. https://doi.org/10.1016/j.ijproman.2005.06.004
Johansen, A., Landmark, A.D., Olshausen, F., van der Kooij, R., Skappel, S (2016). Time elasticity-who and what determines the correct project duration. Procedia Computer Science 100, pp. 586–593. https://doi.org/10.1016/j.procs.2016.09.199
Jun, L., Qiuzhen, W., & Qingguo, M. (2011). The effects of project uncertainty and risk management on IS development project performance: A vendor perspective. International Journal of Project Management, 29(7), pp. 923-933. https://doi.org/10.1016/j.ijproman.2010.11.002
Kalkman, J. P., & de Waard, E. J. (2017). Inter-organizational disaster management projects: Finding the middle way between trust and control. International Journal of Project Management, 35(5), 889-899. https://doi.org/10.1016/j.ijproman.2016.09.013
Karlsen, T J. (2011). Supportive culture for efficient project uncertainty management. International Journal of Managing Projects in Business, 4(2), 240-256. https://doi.org/10.1108/17538371111120225
Knight, F. (1921). Risk, uncertainty and profit. New York: Augustus Kelley.
Koppenjan, J., Veeneman, W., van der Voort, H., ten Heuvelhof, E., & Leijten, M. (2011). Competing management approaches in large engineering projects: The dutch RandstadRail project. International Journal of Project Management, 29(6), 740-750. https://doi.org/10.1016/j.ijproman.2010.07.003
Korhonen, T., Laine, T., & Martinsuo, M. (2014). Management control of project portfolio uncertainty: A managerial role perspective. Project Management Journal, 45(1), 21-37. https://doi.org/10.1002/pmj.21390
Kutsch, E., & Hall, M. (2005). Intervening conditions on the management of project risk: Dealing with uncertainty in information technology projects. International Journal of Project Management, 23(8), pp. 591-599. https://doi.org/10.1016/j.ijproman.2005.06.009
Kvalnes, Ø. (2016). Living with the unknown unknown: uncertainty in projects. Project Management Journal, 47(3), 101-108. http://hdl.handle.net/11250/2400218
Kwon, H. D., Lippman, S. A., McCardle, K. F., & Tang, C. S. (2010). Project management contracts with delayed payments. Manufacturing and Service Operations Management, 12(4), 692-707. https://doi.org/10.1287/msom.1100.0301
Laine, T., Korhonen, T., & Martinsuo, M. (2016). Managing program impacts in new product development: An exploratory case study on overcoming uncertainties. International Journal of Project Management, 34(4), 717-733. https://doi.org/10.1016/j.ijproman.2016.02.011
Laslo, Z., & Goldberg, A. I. (2008). Resource allocation under uncertainty in a multi-project matrix environment: Is organizational conflict inevitable? International Journal of Project Management, 26(8), pp. 773-788. https://doi.org/10.1016/j.ijproman.2007.10.003
Laufer, A. (1991). Construction planning in uncertain environments. International Journal of Project Management, 9(1), pp. 53-60. https://doi.org/10.1016/0263-7863(91)90057-3
Laufer, A., & Cohenca, D. (1990). Factors affecting construction-planning outcomes. Journal of Construction Engineering and Management, 116(1), pp. 135-156. https://doi.org/10.1061/(ASCE)0733-9364(1990)116:1(135)
Lechler, TG, Edington, BH, & Gao, T. (2012). Challenging Classic Project Management: Turning Project Uncertainties Into Business Opportunities. Project Management Journal, 59-69. https://doi.org/10.1002/pmj.21304
Lee, H. -., Shin, J. -., Park, M., & Ryu, H. -. (2009). Probabilistic duration estimation model for high-rise structural work. Journal of Construction Engineering and Management, 135(12), pp. 1289-1298. https://doi.org/10.1061/(ASCE)CO.1943-7862.0000105
Lehner, J. M. (2009). The staging model: The contribution of classical theatre directors to project management in development contexts. International Journal of Project Management, 27(3), pp. 195-205. https://doi.org/10.1016/j.ijproman.2008.02.010
Leung, M. -., Chan, Y. -., & Olomolaiye, P. (2008). Impact of stress on the performance of construction project managers. Journal of Construction Engineering and Management, 134(8), pp. 644-652. https://doi.org/10.1061/(ASCE)0733-9364(2008)134:8(644)
Li, H., Arditi, D., & Wang, Z. (2013). Factors that affect transaction costs in construction projects. Journal of Construction Engineering and Management, 139(1), pp. 60-68. https://doi.org/10.1061/(ASCE)CO.1943-7862.0000573
Light, R.J., & Pillemer, D.B. (1984). Summing up: The science of reviewing research. Cambridge, MA: Harvard University Press.
Lin, C. & Chen, Y. (2004). Bid/no-bid decision-making - A fuzzy linguistic approach. International Journal of Project Management, 22(7), pp. 585-593. https://doi.org/10.1016/j.ijproman.2004.01.005
Lindau, R.A. and Lumsden, K.R. (1995), “Action taken to prevent the propagation of disturbances in manufacturing systems”, International Journal of Production Economics, Vol. 41 Nos 1-3, pp. 241-8. https://doi.org/10.1108/14635770510609042
Liu, J. Y. C., Chen, H. -., Chen, C. C., & Sheu, T. S. (2011). Relationships among interpersonal conflict, requirements uncertainty, and software project performance. International Journal of Project Management, 29(5), 547-556. https://doi.org/10.1016/j.ijproman.2010.04.007
Liu, Z., Wang, H., & Li, H. (2018). Model of equipment sharing between contractors on construction projects. Journal of Construction Engineering and Management, 144(6). https://doi.org/10.1061/(ASCE)CO.1943-7862.0001485
Long, L. D., & Ohsato, A. (2008). Fuzzy critical chain method for project scheduling under resource constraints and uncertainty. International Journal of Project Management, 26(6), pp. 688-698. https://doi.org/10.1016/j.ijproman.2007.09.012
Lorenz, E.N. (1972) to the American Association for the Advancement of Science in Washington, D.C., Predictability: Does the Flap of a Butterfly's Wings in Brazil set off a Tornado in Texas? https://static.gymportalen.dk/sites/lru.dk/files/lru/132_kap6_lorenz_artikel_the_butterfly_effect.pdf
Martinsuo, M., Korhonen, T., & Laine, T. (2014). Identifying, framing and managing uncertainties in project portfolios. International Journal of Project Management, 32(5), pp. 732-746. https://doi.org/10.1016/j.ijproman.2014.01.014
Mays N, Pope C, Popay J. (2005) Systematically reviewing qualitative and quantitative evidence to inform management and policy making in the health field. Journal of Health Services and Research Policy;10 (Suppl 1) pp. 6–2. https://doi.org/10.1258/13558190543085760
Milliken, F.J (1987). Three types of perceived uncertainty about the environment: State, effect, and response uncertainty, Academy of Management Review, 12, pp. 133–143. https://doi.org/10.2307/257999
Mitchell, V. L., & Nault, B. R. (2007). Cooperative planning, uncertainty, and managerial control in concurrent design. Management Science, 53(3), pp. 375-389. https://doi.org/10.1287/mnsc.1060.0641
Mitropoulos, P., & Howell, G. (2001). Model for understanding, preventing, and resolving project disputes. Journal of Construction Engineering and Management, 127(3), pp. 223-231. https://doi.org/10.1061/(ASCE)0733-9364(2001)127:3(223)
Moret, Y., & Einstein, H. H. (2012). Experience in expert estimation of probabilities and correlations for rail line construction. Journal of Construction Engineering and Management, 138(9), pp. 1103-1106. https://doi.org/10.1061/(ASCE)CO.1943-7862.0000505
Moussa, M., Ruwanpura, J., & Jergeas, G. (2007). CTAN for risk assessments using multilevel stochastic networks. Journal of Construction Engineering and Management, 133(1), 96-101. https://doi.org/10.1061/(ASCE)0733-9364(2007)133:1(96)
Naveh, E. (2007). Formality and discretion in successful R&D projects. Journal of Operations Management, 25(1), pp. 110-125. https://doi.org/10.1016/j.jom.2006.02.004
Nightingale, P. (2000). The product-process-organisation relationship in complex development projects. Research Policy, 29(7-8), pp. 913-930. https://doi.org/10.1016/S0048-7333(00)00112-8
Nobelius, D. (2004). Towards the sixth generation of R&D management. International Journal of Project Management, 22(5), pp. 369-375. https://doi.org/10.1016/j.ijproman.2003.10.002
Nychka, D., Ellner, S., Gallant, A.R. and McCaffrey, D. (1992) Finding Chaos in Noisy Systems. Journal of the Royal Statistical Society. Series B (Methodological), 54, (2), pp. 399-426
Olsson, N. O. E. (2006). Management of flexibility in projects. International Journal of Project Management, 24(1), pp. 66-74. https://doi.org/10.1016/j.ijproman.2005.06.010
Olsson, R. (2007). In search of opportunity management: Is the risk management process enough? International Journal of Project Management, 25(8), pp. 745-752. https://doi.org/10.1016/j.ijproman.2007.03.005
Oxman, A. D. (1994). Checklists for review articles. British Management journal, 309(September), pp. 648–651. https://doi.org/10.1136/bmj.309.6955.648
Padalkar, M., & Gopinath, S. (2016). Are complexity and uncertainty distinct concepts in project management? A taxonomical examination from literature. International Journal of Project Management, 34(4), pp. 688-700. https://doi.org/10.1016/j.ijproman.2016.02.009
Padilla, E. M., & Carr, R. I. (1991). Resource strategies for dynamic project management. Journal of Construction Engineering and Management, 117(2), pp. 279-293. https://doi.org/10.1061/(ASCE)0733-9364(1991)117:2(279)
Pare, G., Tate, M., Johnstone, D., Kitsiou, S., (2016). Contextualizing the twin concepts of systematicity and transparency in information system literature reviews. European Journal of Information Systems, 25 (6), pp. 493-508. https://doi.org/10.1057/s41303-016-0020-3
Pena-Mora, F., & Park, M. (2001). Dynamic planning for fast-tracking building construction projects. Journal of Construction Engineering and Management, 127(6),pp. 445-456. https://doi.org/10.1061/(ASCE)0733-9364(2001)127:6(445)
Perminova, O., Gustafsson, M., & Wikström, K. (2008). Defining uncertainty in projects - a new perspective. International Journal of Project Management, 26(1), pp. 73-79. https://doi.org/10.1016/j.ijproman.2007.08.005
Pesämaa, O., Eriksson, P. E., & Hair, J. F. (2009). Validating a model of cooperative procurement in the construction industry. International Journal of Project Management, 27(6), 552-559. https://doi.org/10.1016/j.ijproman.2008.10.007
Petit, Y. (2012). Project portfolios in dynamic environments: Organizing for uncertainty. International Journal of Project Management, 30(5), 539-553. https://doi.org/10.1016/j.ijproman.2011.11.007
Phua, F. T. T. (2007). Does senior executives' perception of environmental uncertainty affect the strategic functions of construction firms? International Journal of Project Management, 25(8), pp. 753-761. https://doi.org/10.1016/j.ijproman.2007.03.003
Pillai, A. S., & Tiwari, A. K. (1995). Enhanced pert for programme analysis, control and evaluation: Pace. International Journal of Project Management, 13(1), 39-43. https://doi.org/10.1016/0263-7863(95)95702-F
Pittaway, L., Robertson, M., Munir, K., Denyer, D., & Neely, A. (2004). Networking and innovation: A systematic review of the evidence. International Journal of Management Reviews, 5-6, pp. 137-168. https://doi.org/10.1111/j.1460-8545.2004.00101.x
Ramasesh, R. V., & Browning, T. R. (2014). A conceptual framework for tackling knowable unknown unknowns in project management. Journal of Operations Management, 32(4), pp. 183-204. https://doi.org/10.1016/j.jom.2014.03.003
Sakka, O., Barki, H., & Côté, L. (2016). Relationship between the interactive use of control systems and the project performance: The moderating effect of uncertainty and equivocality. International Journal of Project Management, 34(3), pp. 508-522. https://doi.org/10.1016/j.ijproman.2016.01.001
Saleh, A; Watson, R. (2017). Business excellence in a volatile, uncertain, complex and ambiguous environment (BEVUCA). The TQM Journal, 29(5), pp. 705–724. https://doi.org/10.1108/TQM-12-2016-0109
San-Cristobal, J.R. (2017) Complexity in Project Management. Procedia Computer Science, 121, 762–766. https://doi.org/10.1016/j.procs.2017.11.098
Santiago, L. P., & Vakili, P. (2005). On the value of flexibility in R&D projects. Management Science, 51(8), pp. 1206-1218. https://doi.org/10.1287/mnsc.1050.0387
Saunders JW, Vale P.D and Carvalho M.D (2017) “Risk and uncertainty in projects management: literature review and conceptual framework” GEPROS. Gestão da Produção, Operações e Sistemas, Bauru, Ano 12, nº 2, abr-jun/2017, p. 93-120.
Saunders, F. C., Gale, A. W., & Sherry, A. H. (2015). Conceptualising uncertainty in safety-critical projects: A practitioner perspective. International Journal of Project Management, 33(2), 467-478. https://doi.org/10.1016/j.ijproman.2014.09.002
Saunders, F. C., Gale, A. W., & Sherry, A. H. (2016). Mapping the multi-faceted: Determinants of uncertainty in safety-critical projects. International Journal of Project Management, 34(6), pp. 1057-1070. https://doi.org/10.1016/j.ijproman.2016.02.003
Sauser, B. J., Reilly, R. R., & Shenhar, A. J. (2009). Why projects fail? how contingency theory can provide new insights - A comparative analysis of NASA's mars climate orbiter loss. International Journal of Project Management, 27(7), pp.665-679. https://doi.org/10.1016/j.ijproman.2009.01.004
Schatteman, D., Herroelen, W., Van De Vonder, S., & Boone, A. (2008). Methodology for integrated risk management and proactive scheduling of construction projects. Journal of Construction Engineering and Management, 134(11), pp. 885-893. https://doi.org/10.1061/(ASCE)0733-9364(2008)134:11(885)
Shenhar, A. J. (2001). One size does not fit all projects: Exploring classical contingency domains. Management Science, 47(3), pp. 394-414. https://doi.org/10.1287/mnsc.47.3.394.9772
Scott, S., & Harris, R. A. (2004). United kingdom construction claims: Views of professionals. Journal of Construction Engineering and Management, 130(5), 734-741. https://doi.org/10.1061/(ASCE)0733-9364(2004)130:5(734)
Singh, D., & Tiong, R. L. K. (2005). Development of life cycle costing framework for highway bridges in Myanmar. International Journal of Project Management, 23(1), pp. 37-44. https://doi.org/10.1016/j.ijproman.2004.05.010
Söderlund J. (2011) Pluralism in Project Management: Navigating the Crossroads of Specialization and Fragmentation. International Journal of Management Reviews, 13, pp. 153-176. https://doi.org/10.1111/j.1468-2370.2010.00290.x
Sommer, S.C., Loch, C.H., Dong, J., (2009). Managing complexity and unforeseeable uncertainty in startup companies: an empirical study. Organization Science 20, pp. 118–133. https://doi.org/10.1287/orsc.1080.0369
Sommer, S. C., & Loch, C. H. (2004). Selectionism and learning in projects with complexity and unforeseeable uncertainty. Management science, 50(10), 1334-1347. https://doi.org/10.1287/mnsc.1040.0274
Starbuck, W. H., & Milliken, F. J. (1988). Executives’ perceptual filters: What they notice and how they make sense. In D. C. Hambrick (Ed.), The executive effect: Concepts and methods for studying top managers (pp. 35–65). Greenwich, CT: JAI Press.
Sundararajan, S. K., & Tseng, C. -. (2017). Managing project performance risks under uncertainty: Using a dynamic capital structure approach in infrastructure project financing. Journal of Construction Engineering and Management, 143(8). https://doi.org/10.1061/(ASCE)CO.1943-7862.0001341
Svejvig, P., & Andersen, P. (2015). Rethinking project management: A structured literature review with a critical look at the brave new world. International Journal of Project Management, 33(2), pp. 278-290. https://doi.org/10.1016/j.ijproman.2014.06.004
Tatikonda, M. V., & Montoya-Weiss, M. M. (2001). Integrating operations and marketing perspectives of product innovation: The influence of organizational process factors and capabilities on development performance. Management Science, 47(1), pp. 151-172. https://doi.org/10.1287/mnsc.47.1.151.10669
Teece, D. J., & Leih, S. (2016). Uncertainty, innovation, and dynamic capabilities: An introduction. California Management Review, 58(4), pp. 5–12. https://doi.org/10.1525/cmr.2016.58.4.5
Thietart, R. A., Forgues, B. (1985) Chaos Theory and Organization. Organization Science. 6 (1), pp. 19-31.
Thiry, M. (2002). Combining value and project management into an effective programme management model. International Journal of Project Management, 20(3), 221-227. https://doi.org/10.1016/S0263-7863(01)00072-2
Thyer, B. A. (2008). Preparing Research Articles. Oxford university press
Torchia, M. & Calabrò, A., (2019). Open Innovation in SMEs: A Systematic Literature Review. Journal of Entreprising Culture, 27, (2), 201-228. https://doi.org/10.1142/S0218495819500080
Tranfield, D., Denyer, D. & Smart, P. (2003). Towards a methodology for developing evidence-informed management knowledge by means of systematic review. British Journal of Management, 14, pp. 207–222. https://doi.org/10.1111/1467-8551.00375
Turner, J. R., & Müller, R. (2003). On the nature of the project as a temporary organization. International Journal of Project Management, 21(1), pp. 1-8. https://doi.org/10.1016/S0263-7863(02)00020-0
Turner, J. R., & Simister, S. J. (2001). Project contract management and a theory of organization. International Journal of Project Management, 19(8), pp. 457-464. https://doi.org/10.1016/S0263-7863(01)00051-5
Turner, J.R., Cochrane, R., (1993). Goals-and-methods matrix: coping with projects ill-defined goals and/or methods of achieving them. International Journal of Project Management, 11, pp. 93–102. https://doi.org/10.1016/0263-7863(93)90017-H
Tysseland, B. E. (2008). Life cycle cost based procurement decisions. A case study of norwegian defence procurement projects. International Journal of Project Management, 26(4), pp. 366-375. https://doi.org/10.1016/j.ijproman.2007.09.005
Van Asselt, M.B.A. and Rotmans, J. (2002). Uncertainty in Integrated Assessment Modelling: from Positivism to Pluralism; Climate Change 54, pp. 75–105.
Van Der Velde, R. R., & Van Donk, D. P. (2002). Understanding bi-project management: Engineering complex industrial construction projects. International Journal of Project Management, 20(7), pp. 525-533. https://doi.org/10.1016/S0263-7863(01)00053-9
Van Marrewijk, A., Clegg, S. R., Pitsis, T. S., & Veenswijk, M. (2008). Managing public-private megaprojects: Paradoxes, complexity, and project design. International Journal of Project Management, 26(6), pp. 591-600. https://doi.org/10.1016/j.ijproman.2007.09.007
Vaziri, K., Carr, P. G., & Nozick, L. K. (2007). Project planning for construction under uncertainty with limited resources. Journal of Construction Engineering and Management, 133(4), pp. 268-276. https://doi.org/10.1061/(ASCE)0733-9364(2007)133:4(268)
Verworn, B. (2009). A structural equation model of the impact of the "fuzzy front end" on the success of new product development. Research Policy, 38(10), pp. 1571-1581. https://doi.org/10.1016/j.respol.2009.09.006
Vuorinen, L., & Martinsuo, M. (2018). Program integration in multi-project change programs: Agency in integration practice. International Journal of Project Management, 36(4), 583-599. https://doi.org/10.1016/j.ijproman.2018.02.003
Walsh, I. and Renaud, A. (2017), "Reviewing the literature in the IS field: Two bibliometric techniques to guide readings and help the interpretation of the literature", Systèmes d’Information & Management, Vol. 22 No. 3, pp. 75-114
Wang, W. & Liu, J. (2005). Factor-based path analysis to support subcontractor management. International Journal of Project Management, 23(2), pp. 109-120. https://doi.org/10.1016/j.ijproman.2004.07.011
Ward, S., & Chapman, C. (2003). Transforming project risk management into project uncertainty management. International Journal of Project Management, 21(2), pp. 97-105. https://doi.org/10.1016/S0263-7863(01)00080-1
Wazed M., Shamsuddin A. and Yusoff N. (2009). Uncertainty factors in real manufacturing environment. Australian Journal of Basic and Applied Sciences, 3(2), pp. 342-351
Werndl, C. (2009). What are the New Implications of Chaos for Unpredictability? The British Journal for the Philosophy of Science. 60 (1), pp. 195–220
Williams, T., (2005). Assessing and moving on from the dominant project management discourse in the light of project overruns. IEEE Transactions of Engineering Management 52, pp. 497–508
Witt P.W., Baker T., Ashley N.W., Winniford M. (2017), “Is personality a key element of Six Sigma project success? International Journal of Services and Operations Management. 27 (4). https://doi.org/10.1504/IJSOM.2017.10005702
Wong, K., Unsal, H., Taylor, J. E., & Levitt, R. E. (2010). Global dimension of robust project network design. Journal of Construction Engineering and Management, 136(4), 442-451. https://doi.org/10.1061/(ASCE)CO.1943-7862.0000143
Wong, W. K., Cheung, S. O., Yiu, T. W., & Pang, H. Y. (2008). A framework for trust in construction contracting. International Journal of Project Management, 26(8), 821-829. https://doi.org/10.1016/j.ijproman.2007.11.004
Wouters, M., J.C. Anderson, J.A. Narus and F. Wynstra (2009). ‘‘Improving Sourcing Decisions in NPD Projects: Monetary Quantification of Points of Difference,’’ Journal of Operations Management, 27 (1), pp. 64-77. https://doi.org/10.1016/j.jom.2008.07.001
Xiang, P., Huo, X., & Shen, L. (2015). Research on the phenomenon of asymmetric information in construction projects - the case of china. International Journal of Project Management, 33(3), 589-598. https://doi.org/10.1016/j.ijproman.2014.10.007
Xiang, P., Zhou, J., Zhou, X., & Ye, K. (2012). Construction project risk management based on the view of asymmetric information. Journal of Construction Engineering and Management, 138(11), 1303-1311. https://doi.org/10.1061/(ASCE)CO.1943-7862.0000548
Yang, I. & Chang, C. -. (2005). Stochastic resource-constrained scheduling for repetitive construction projects with uncertain supply of resources and funding. International Journal of Project Management 23(7), 546-553. https://doi.org/10.1016/j.ijproman.2005.03.003
You, J., Chen, Y., Wang, W., & Shi, C. (2018). Uncertainty, opportunistic behavior, and governance in construction projects: The efficacy of contracts. International Journal of Project Management, 36(5), 795-807. https://doi.org/10.1016/j.ijproman.2018.03.002
Zayed, T., Amer, M., & Pan, J. (2008). Assessing risk and uncertainty inherent in Chinese highway projects using AHP. International Journal of Project Management, 26(4), 408-419. https://doi.org/10.1016/j.ijproman.2007.05.012
Zhang, S., Pan, F., Wang, C., Sun, Y., & Wang, H. (2017). BIM-based collaboration platform for the management of EPC projects in hydropower engineering. Journal of Construction Engineering and Management, 143(12). https://doi.org/10.1061/(ASCE)CO.1943-7862.0001403
Zheng, E.Z.H., & Carvalho, M.M. de, (2016). Managing uncertainty in projects: a review, trends and gaps. Revista Gestão e Projetos 07, pp. 95–109.
Amitabh Anand is an Associate Professor at Excelia Business School, La Rochelle, France. His research interest includes Ethics, Organizational Behavior, International Management, Entrepreneurship, and Bibliometrics. His research has been presented internationally and published within the Journal of Business Venturing, Journal of Knowledge Management, Journal of Retailing and Consumer Services, Personnel Review, Management International, Computers in Human Behaviour, etc.
Alessio Castello is an Associate professor of Innovation Management at the International University of Monaco, where he is also Head of the Strategy and Management department. His research interests include innovation and entrepreneurship management, and, more recently, he started working on decision-making strategies and processes in environments characterized by high levels of VUCA and applicable to several industries. His research has been presented internationally and published in journals such as R&D Management, MIT Sloan management review, International Journal of Technology Management, Journal of Behavioural and Experimental Finance, etc.
Laurence Lecoeuvre is presently non-affiliated. She was a full professor at International University of Monaco and at SKEMA. She had taught management, project management and research methods ; international management and strategic marketing. She published regularly at top journal as chapters and books.
1 Amitabh Anand, Excelia Business School, CERIIM, La Rochelle, France, ananda@excelia-group.com N°ORCID : https://orcid.org/0000-0001-6649-6422
2 Alessio Castello, International University of Monaco–Omnes Education acastello@monaco.edu , N° ORCID : https://orcid.org/0000-0003-3888-8570
3 Laurence Lecoeuvre Non-affiliate, laurence.lecoeuvre06@gmail.com
